Functional structure
What data is stored, how records relate, and what actions are possible.
Selected work / 03 · Project Sheet
Project Sheet combines database logic with spreadsheet presentation. I used both to build a design approach, investigate tasks and prioritize problems, then address task dependencies through two connected areas: improving the Gantt view and defining the field’s interactions.
Explore the design process01 — Understand the product
Project Sheet serves focused scenarios such as project management and CRM. Its data logic draws on databases, while its presentation draws on spreadsheets. I analyzed requirements through both functional structure and information organization, considering how data and actions work together and how people understand them.
What data is stored, how records relate, and what actions are possible.
How the same data is arranged so people can understand it and act.
How can these two characteristics become a practical design method?
02 — Build the method
For functional structure, I used create, delete, read, and update to check interaction completeness, from configuring a field to entering its cell content. For information organization, I examined views, toolbar operations, and fields: how a field appears across views and behaves under grouping or filtering.
Configure the field; add cell content.
Locate the record; understand the relationship.
Change content and related states.
Remove the intended object with clear feedback.
The form of a record across grid, Gantt, gallery and Kanban.
The effects of grouping, filtering and hiding fields.
The meaning, constraints and content of a cell.
Alongside the operation-based checks, I can explain the design through what people need to accomplish: arrange work, understand its timing and adjust related tasks. The concrete proposals below show how each job connects to an obstacle and a design response.
Task order and dependency direction need to be understood across views.
Consistent relationship types, labels and arrow directions, with creation from fields or Gantt endpoints.
Explore the designFields compete for space; dates and milestones become hard to distinguish at larger scales.
Focus the main field, show owners in the Gantt area, and reveal exact dates and grouped milestones.
Explore the designBatch edits and parent-child changes need clear, coherent range behavior.
Connect multi-selection, batch date changes, parent-child rules and an option to disable dependency-date linkage.
Explore the designApply the same checks to a concrete task-dependency requirement.
03 — Requirements & research
Task dependencies help teams understand sequence and timing, with the Gantt view providing a key context. Existing usability issues could undermine the new field, so I worked with product to divide the work into dependency design and improvements to the Gantt view.
Resolve the usability issues in the view that will carry the new relationship.
Design how a dependency is created, recognized, changed and removed.
Competitive research examined entry points, direction, display, editing and removal through the same action framework. Familiar arrows and fields provided the foundation; the design focus moved to micro-interactions and UI details.
Two experienced test colleagues, three people new to the feature, and three light users participated in qualitative research. The observations locate usability problems; they do not establish population-level success rates.
Match the date fields and establish the first time bar.
Change dates for several tasks and understand parent–child timing.

Tasks were organized by action dimension. The appendix contains multiple task groups; no completion-rate or timing scores have been added.
04 — Priorities & scope

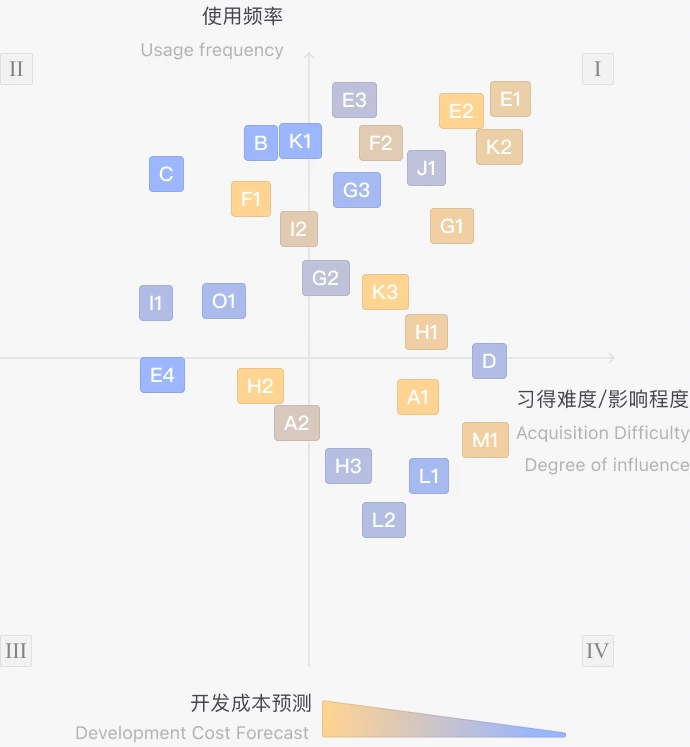

Not every issue needed to be solved in the same release. I considered frequency, learning difficulty and impact, with development cost constraining scope. Related findings were then grouped into three areas of improvement, each checked for other problems it could address.
Focus on the primary field; put owners in the Gantt area; make hidden fields recoverable.
Too many field columns take up too much page space.
When collapsing columns, I want to keep the title column.
I do not know how to reopen hidden columns.
I cannot see task owners without expanding the fields on the left.
Clarify time scales, exact dates and milestone placement.
I cannot tell precise start and end dates at month, quarter, half-year or year scales.

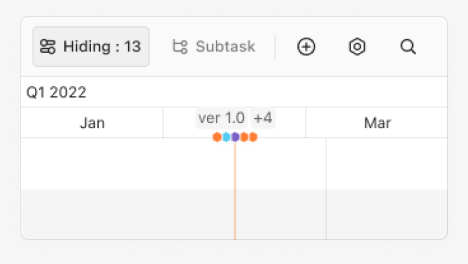

I cannot tell the exact milestone date at month, quarter, half-year or year scales.
Multiple milestones are hard to distinguish.
At large time scales, I cannot see the new date after an edit.
Connect selection, batch edits and parent–child ranges.
Adjusting the order of several rows is inconvenient.
The handle for changing a subtask’s date is too small.
Parent and child time bars do not automatically adapt to changes.
First make the Gantt foundation work. Then bring the dependency into it.
05 — Workstream A · Gantt view
The Gantt improvements addressed three priorities: allocating space to essential information, making dates readable at different scales, and defining consistent interactions for multiple tasks.
Problem · fields occupy the view, while owners require another lookup.

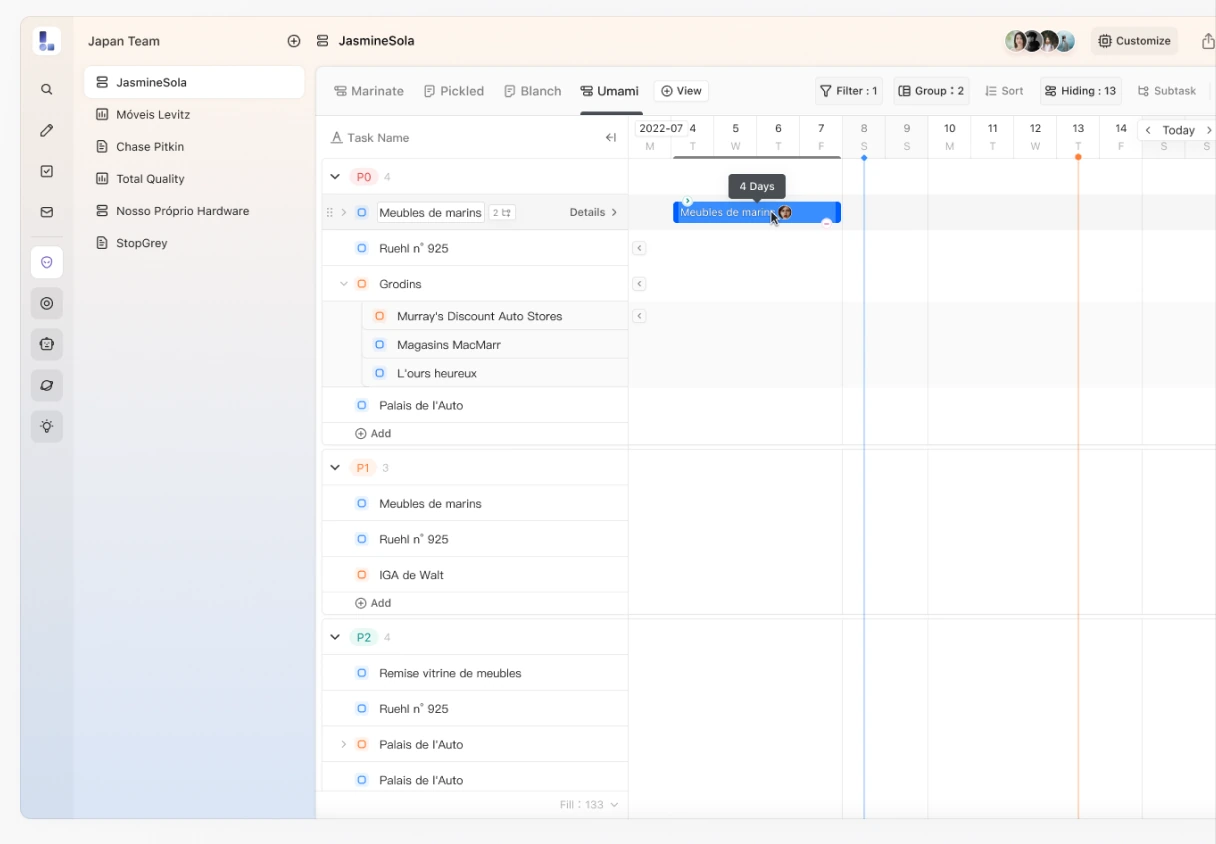

Focus the field area on the primary key. Move owner avatars into the Gantt area and duration into hover feedback. Keep explicit controls to collapse and restore other fields.
Problem · large scales obscure exact ranges and merge milestone positions.

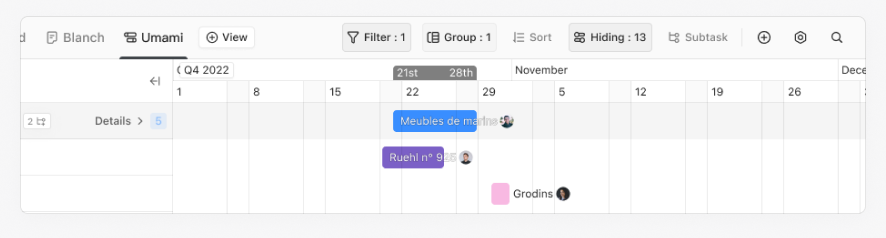

Distinguish dates and weekends at week, month and quarter scales. Reveal the exact range when a time bar is in focus; define milestone positions and aggregate those within the same unit.
Problem · batch changes and parent–child edits follow disconnected rules.

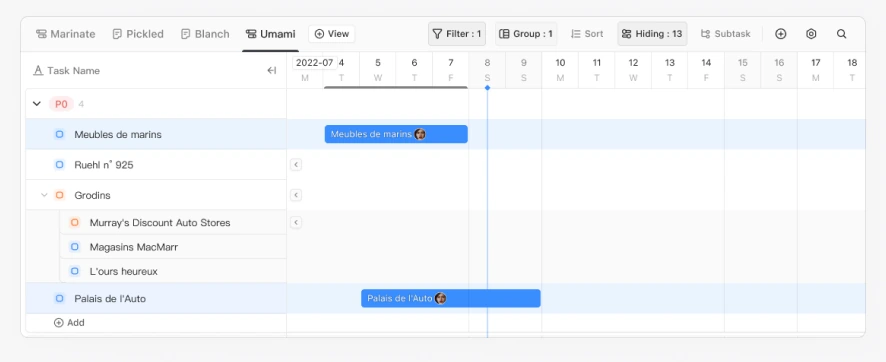

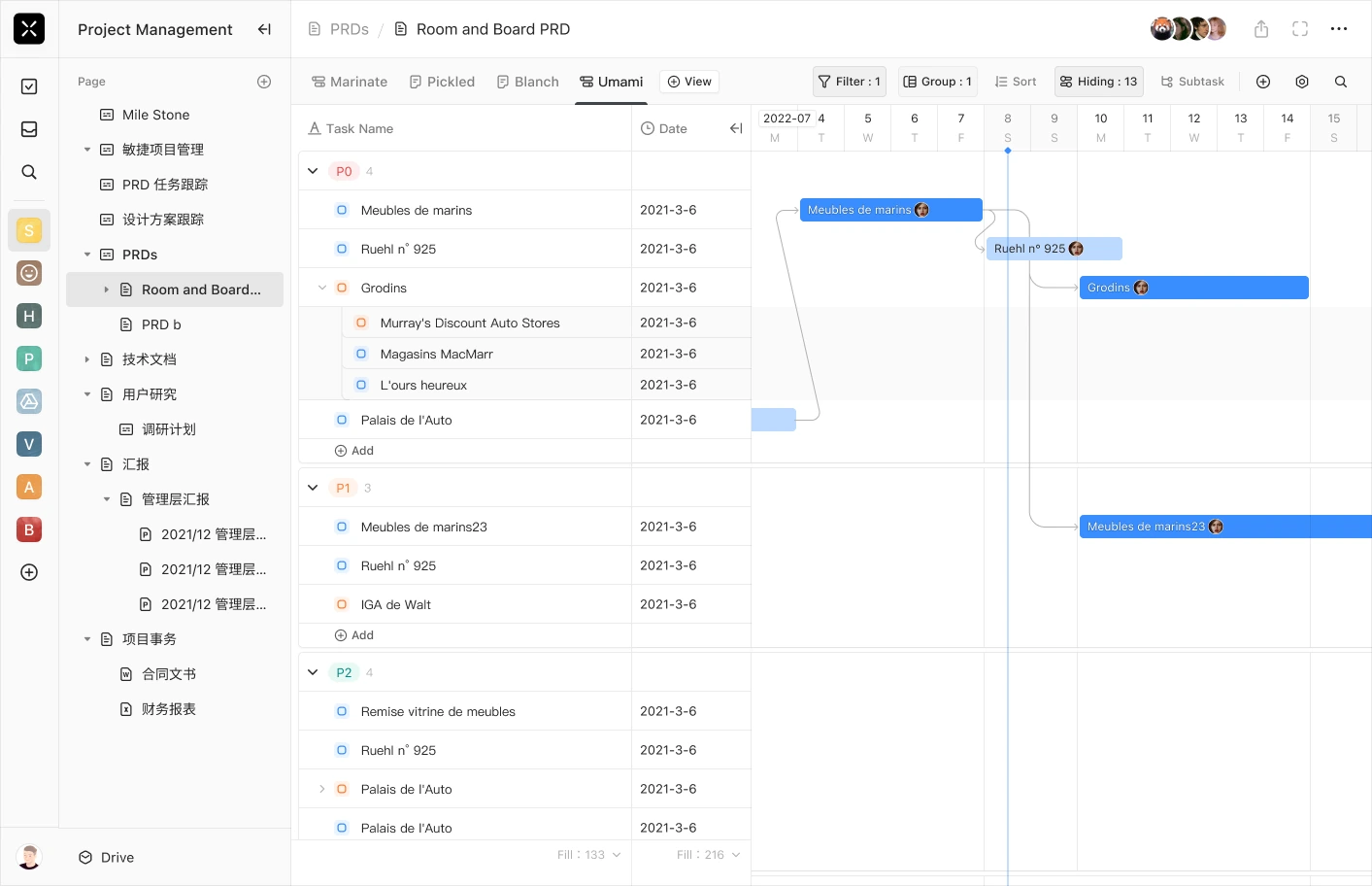

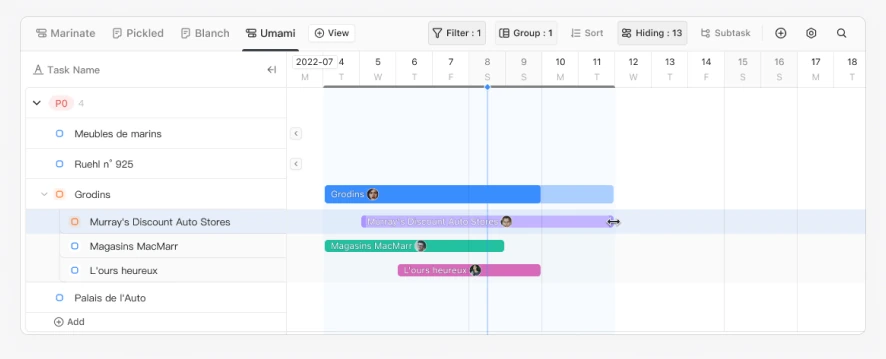

Click a time bar to select it; use Shift for multi-selection. Batch date edits and dragging follow the same change. In the original design, shrinking a parent pulls children into its range; extending a child expands the parent.
06 — Workstream B · Task dependencies
With the Gantt foundation addressed, I returned to the method to define how dependencies are created, recognized, changed, and removed. I checked their behavior across the grid, Gantt view, detail panel, and other views to maintain a consistent understanding of relationship direction.

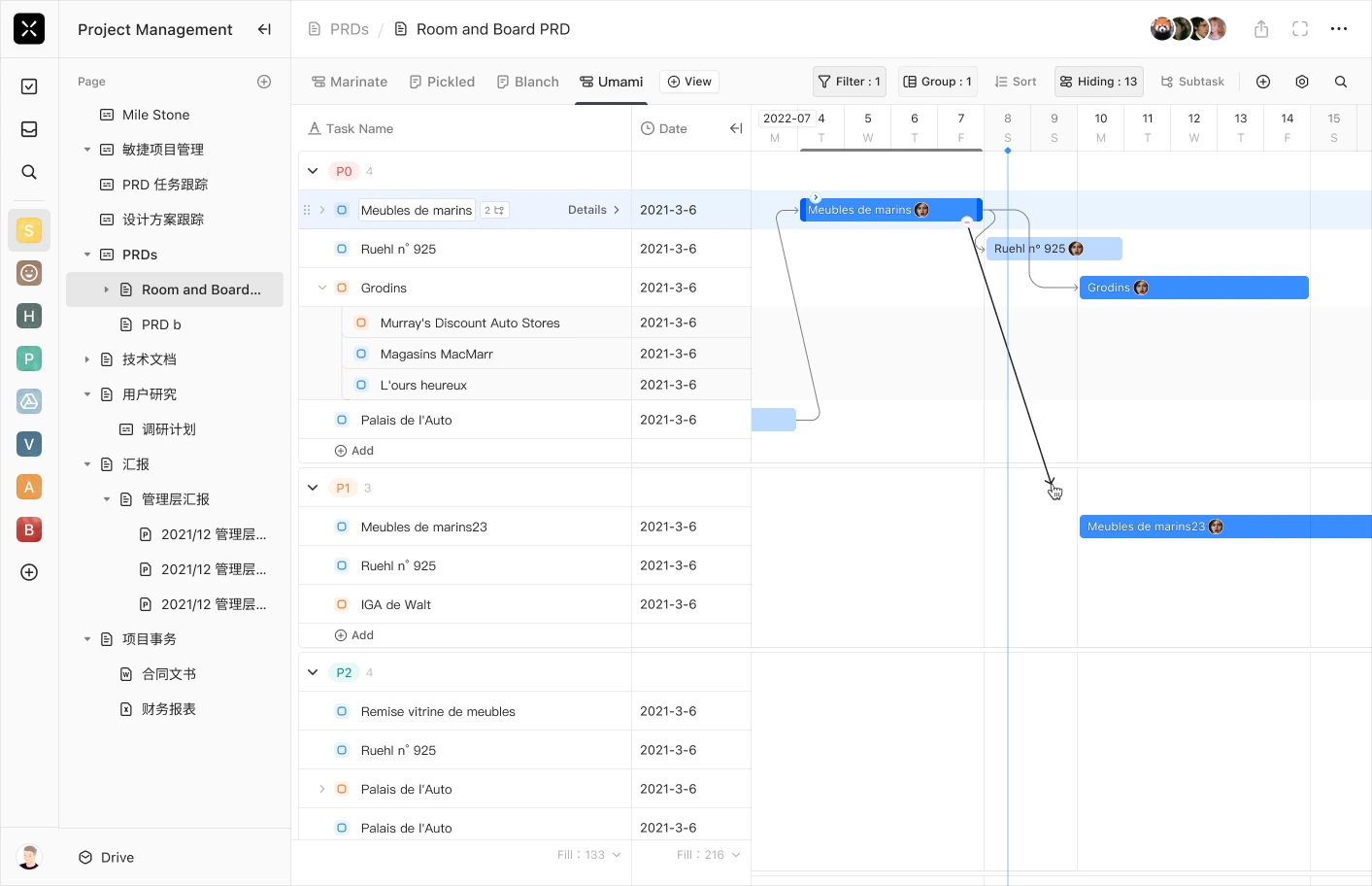

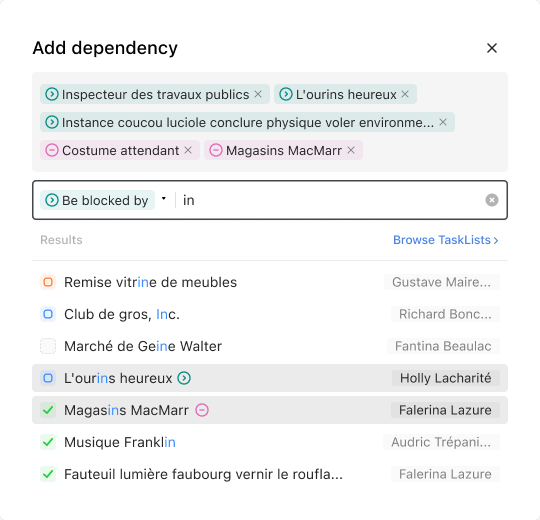

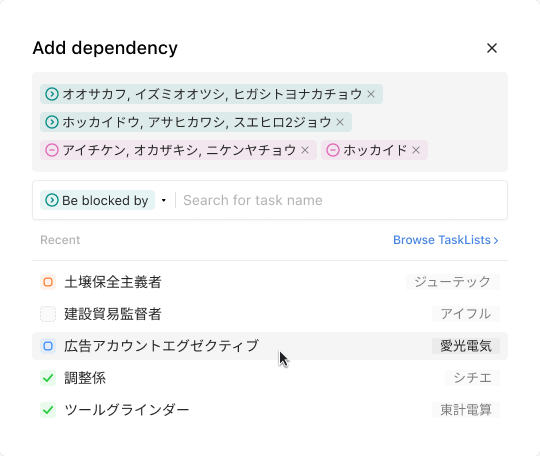

In the grid, choose a relationship type and search for a task. In Gantt, drag from a time-bar endpoint. Matching icons and arrows clarify the direction, target and completed state.

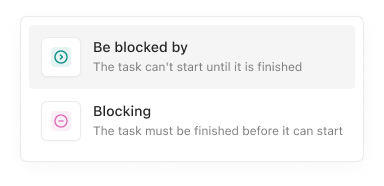

Existing dependencies cannot be created again, and dependencies cannot be created between parent and child tasks. Time conflicts use red lines and label icons; a logical conflict makes the dragged line bounce back.

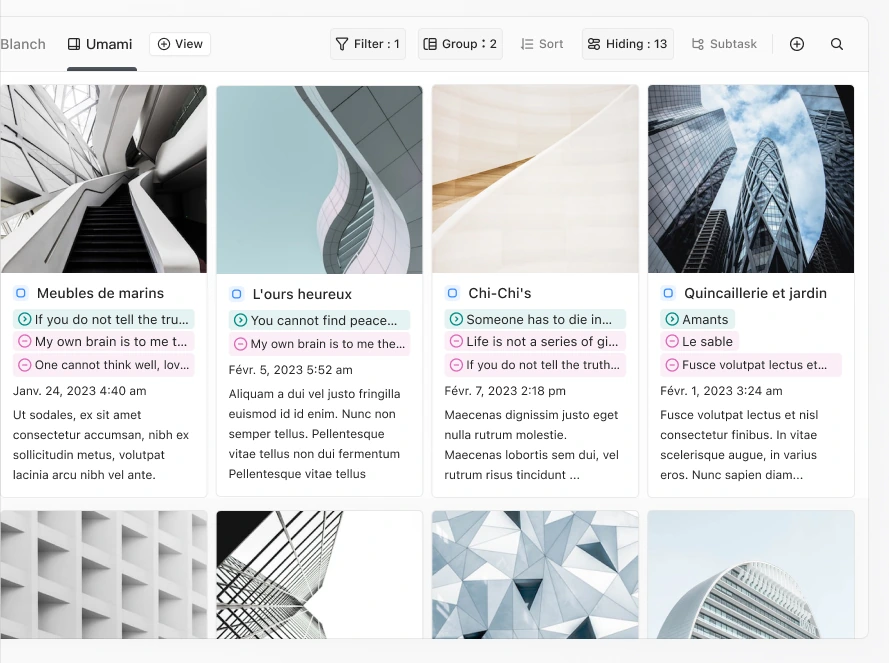

Dependency tags need to differ from linked-record and multi-select fields. Color and symbols work together, and gallery or Kanban views use one relationship per row. Gantt paths reveal the same relationship spatially.

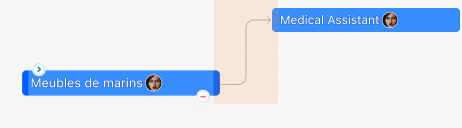

The original design defines Z-shaped, stepped and snake-shaped paths for different positions. Hover emphasizes related paths; grouping is considered alongside the line rules. Frame 12 also describes a click entry point for editing or removal.

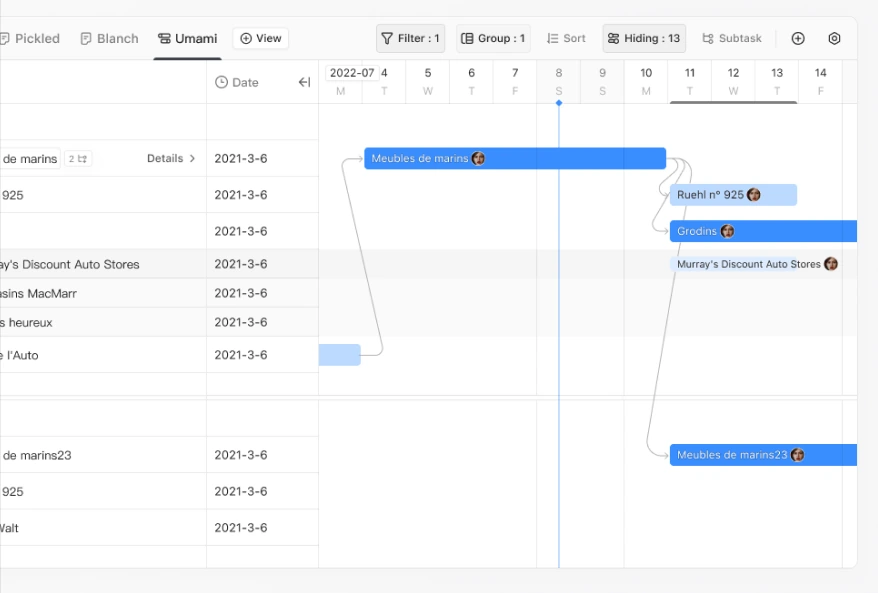

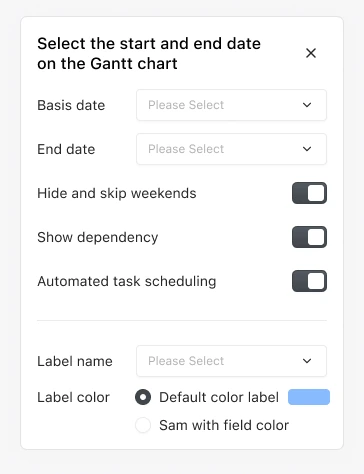

When a task moves, should the tasks that depend on it move too? I linked their dates and added a setting for teams that prefer to reschedule each one themselves. A relationship can be removed and added again in the cell, or its type can be edited directly in the detail panel.
Removal should make the current target clear. Keep the entry close to the tag or connection, and emphasize the relationship being acted on.

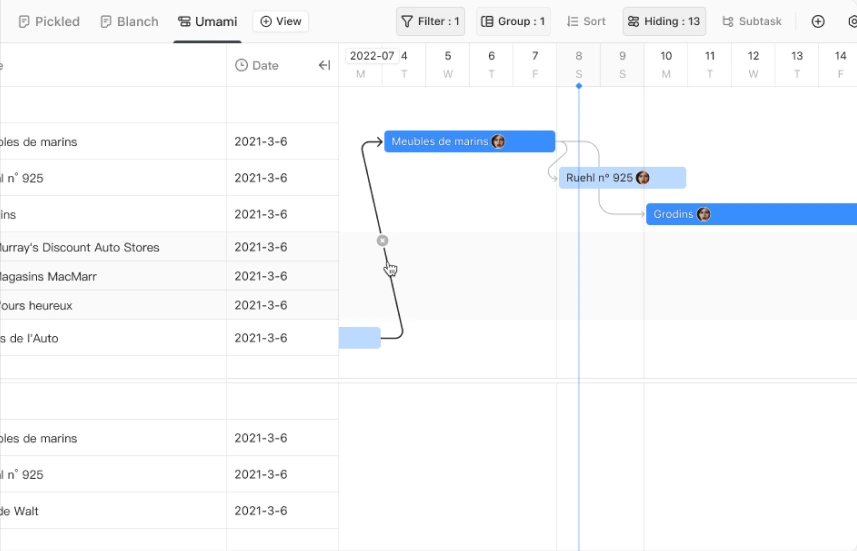

The deleted object is the relationship, not the task. Table and detail entries remove the tag. Frame 14 shows hover-to-remove on a line; the click entry in Frame 12 is retained as a separate source description rather than combined into an invented final rule.
07 — Component-based delivery

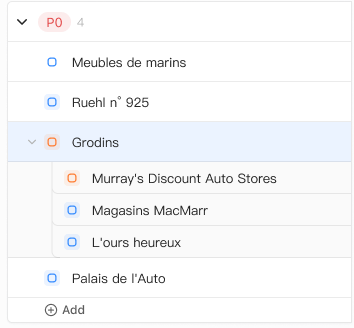

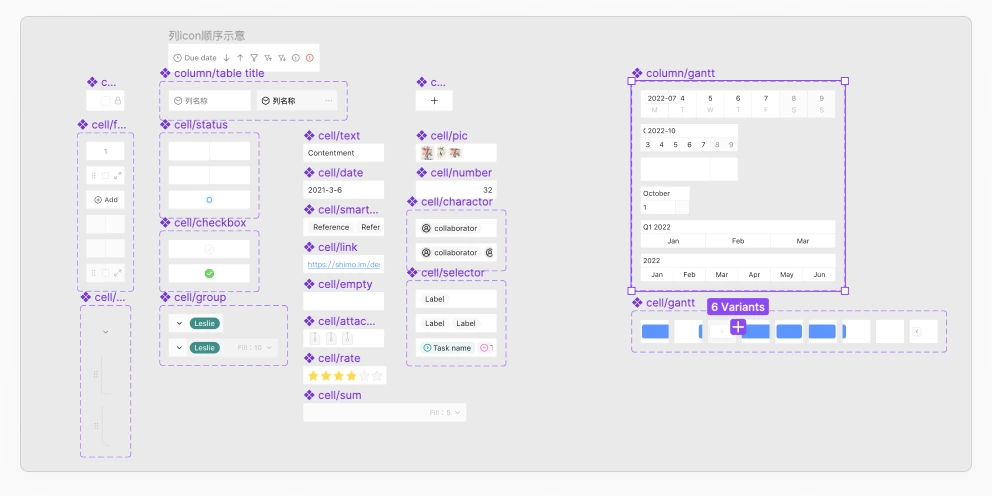

The design logic also informed the way the files were built. I separated the Gantt view into the task list, timeline, and time bars, using components and Figma layout parameters to support consistent states and changes.
row/ganttHorizontal layout · 343 × 40 · spacing 0
column/ganttVertical layout · 336 × 48 · spacing 0
cell/ganttFixed cell · 48 × 40
08 — Outcomes & reflection
The original review reports a 3.4% rise in Gantt usage frequency following the November 2022 release, alongside a separate account of addressing enterprise customer needs. My takeaway is the connection between product understanding, research, prioritization, and detailed interaction design.
PROJECT SHEET · PRODUCT EXPERIENCE
I connected research, feature planning and interaction design, prioritizing Gantt improvements and dependency fields within the broader product experience.
−24%
Decrease across Project Sheet overall.
4.2 → 4.5
Improvement in the overall product rating.
These two measures cover Project Sheet overall. Gantt usage frequency is presented separately below.
Gantt chart usage frequency
The accumulation here is a continuous line from product understanding to research, priorities and interaction details. Data logic, information organization and each action check one another.

The review separately records responses to enterprise customer needs. The feedback chart below is not the measurement behind the 3.4% usage change.
Completeness in a complex tool comes from checking data logic, information organization, and each action against one another.
